Explore the Kiten / KOIVU project

This is a real LIND.HOMES project. Review the timeline, budget, services and weekly structure — then start building your own future project.

Project overview

Kiten / KOIVU

Project code

KITEN-KOIVU-001

House model

KOIVU

Location

Kiten, Varna Bulgaria

Project type

Land plot + prefabricated KOIVU home

Area

63 m2 total

Modules

2

Site Development

Demolition, clearing, access road, site readiness and foundation completed. Foundation reached 100% on 15.07.2026.

KOIVU home production

House production is 85% ready. Delivery is planned for 16.11.2026.

Project schedule

Project Schedule

A clear customer timeline for progress, payments, weekly reports and services.

Today

Oct 30, 2026: Delivery is the active phase.

Nov 13, 2025 - Jul 7, 2026
✓

Site preparation

Completed 100%

Landplot ready for works

2 payments 1 report 2 services Expand

Responsible

Site team

Duration

Site workstream

Related payments

Demolition and site preparation: €11,000 · Paid · 13.11.2025

Site works and hydrology correction: €10,000 · Paid · 25.06.2026

Reports & services

Week 3: Published

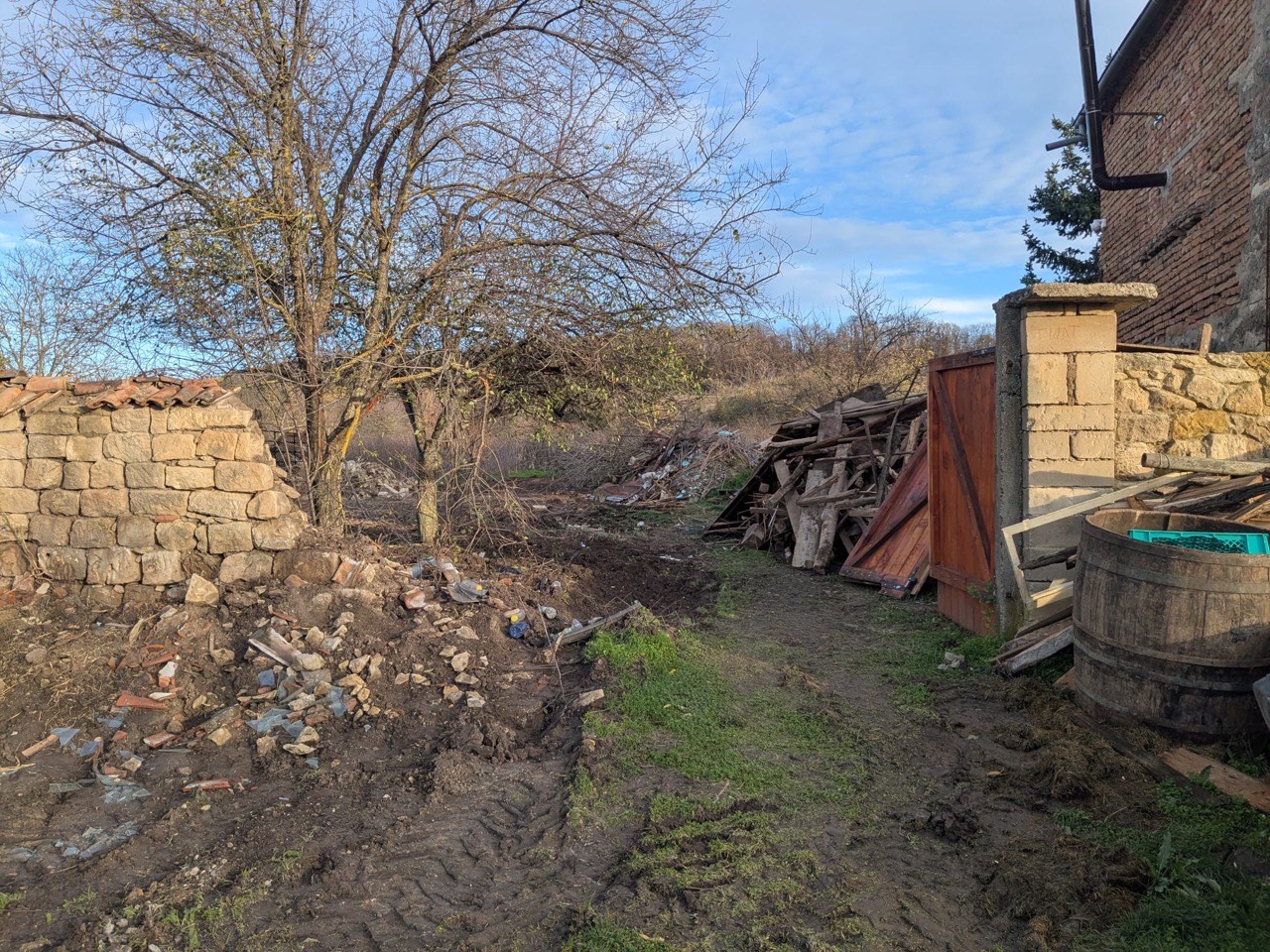

Old building demolition

Site ready

Jun 17, 2026 - Jun 23, 2026
✓

Documents & verification

Completed 100%

Project file verified

1 service Expand

Responsible

LIND.HOMES customer care

Duration

1 week

Related payments

No payments linked.

Reports & services

No weekly reports linked.

Architectural documentation & permits

Jun 24, 2026 - Jun 30, 2026
✓

Contracts

Completed 100%

Customer agreements confirmed

2 payments 1 service Expand

Responsible

LIND.HOMES operations

Duration

1 week

Related payments

Site works and hydrology correction: €10,000 · Paid · 25.06.2026

Kitchen order: €3,721 · Paid · 28.06.2026

Reports & services

No weekly reports linked.

IKEA kitchen order

Jun 25, 2026 - Nov 15, 2026

Production

Upcoming 85%

KOIVU production 85% ready

1 payment 2 reports Expand

Responsible

Supplier

Duration

Production through delivery preparation

Related payments

Second payment: 40%: €21,600 · Upcoming · 01-10.07.2026

Reports & services

Week 7: Published

Week 9: Published

No services linked.

Jul 8, 2026 - Jul 15, 2026
✓

Foundation

Completed 100%

Foundation ready for assembly

1 payment 1 report 1 service Expand

Responsible

Site team

Duration

8 days

Related payments

Second payment: 40%: €21,600 · Upcoming · 01-10.07.2026

Reports & services

Week 5: Published

Foundation

Nov 16, 2026
•

Delivery

Current 10%

Carrier contracts confirmed · delivery planned for 16.11.2026

Expand

Responsible

Logistics team

Duration

Logistics preparation and delivery

Related payments

No payments linked.

Reports & services

No weekly reports linked.

No services linked.

Nov 17, 2026 - Nov 20, 2026

Assembly

Upcoming 0%

Assembly planned until 20.11.2026

1 payment 1 report Expand

Responsible

Assembly team

Duration

4 days

Related payments

Final payment: 10%: €5,400 · Scheduled · After acceptance protocol

Reports & services

Week 5: Published

No services linked.

Nov 20, 2026 - Nov 24, 2026

Utilities & equipment

Upcoming 70%

Utilities and equipment 70% ready

3 services Expand

Responsible

Utility partners

Duration

5 days

Related payments

No payments linked.

Reports & services

No weekly reports linked.

Water connection

Electricity connection

Septic system

Nov 24, 2026 - Nov 29, 2026

Interior & final works

Upcoming 70%

Interior and final works 70% ready

1 report 1 service Expand

Responsible

Finishing team

Duration

6 days

Related payments

No payments linked.

Reports & services

Week 7: Published

JYSK furniture order

Nov 30, 2026 - Dec 1, 2026

Inspection & acceptance

Upcoming 0%

Vendor, technical and buyer inspection

Expand

Responsible

Project manager

Duration

2 days

Related payments

No payments linked.

Reports & services

No weekly reports linked.

No services linked.

Dec 2, 2026

Warranty

Upcoming 0%

Warranty starts

Expand

Responsible

LIND.HOMES support

Duration

Starts Dec 2, 2026

Related payments

No payments linked.

Reports & services

No weekly reports linked.

No services linked.

Dec 2, 2026 - Dec 15, 2026

Final permits & completion documents

Upcoming 40%

Final permits and completion documents 40% ready

1 service Expand

Responsible

LIND.HOMES operations

Duration

Admin follow-up

Related payments

No payments linked.

Reports & services

No weekly reports linked.

Architectural documentation & permits

Project budget

Budget and agreements

Total contracted excl. VAT

€82,697

All project values are shown excluding VAT unless otherwise stated.

Total paid excl. VAT

€49,997

Remaining excl. VAT

€33,700

Upcoming excl. VAT

€33,700

01-10.07.2026

Financial status

On track

Combined payment timeline

Combined Payment Timeline

Week of Nov 10

€11K

Paid

1 payment · tap for details

Demolition and site preparation

Site Preparation Agreement

€11,000

Paid 13.11.2025

Schedule: Site preparation

Week of Mar 16

€27K

Paid

1 payment · tap for details

First payment to supplier

House Supply Agreement

€27,000

Paid 20.03.2026

Week of Apr 20

€2K

Paid

1 payment · tap for details

JYSK furniture order

Additional Services Agreement

€1,996.78

Paid 25.04.2026

Week of Jun 22

€10K

Paid

2 payments · tap for details

Site works and hydrology correction

Site Preparation Agreement

€10,000

Paid 25.06.2026

Schedule: Contracts / Site preparation

Kitchen order

Additional Services Agreement

€3,720.86

Paid 28.06.2026

Schedule: Contracts

Week of Jul 6

€21.6K

Upcoming

1 payment · tap for details

Second payment: 40%

House Supply Agreement

€21,600

Upcoming 01-10.07.2026

Schedule: Foundation / Production

Week of Jul 13

€5.4K

Upcoming

1 payment · tap for details

Final payment: 10%

House Supply Agreement

€5,400

Upcoming After acceptance protocol

Schedule: Assembly

To confirm

€6.7K

! Attention Required

2 payments · tap for details

Hydrology correction

Additional Services Agreement

€2,000

! Attention Required To confirm

Building permit cost increase

Additional Services Agreement

€4,700

! Attention Required To confirm

House Supply Agreement

€54K

Active ⌄

Foundation works are performed under the Site Preparation Agreement. Foundation value (~€5K) is excluded from the House Supply Agreement scope for this project.

Contract value excl. VAT

€54,000

Paid excl. VAT

€27,000

Remaining excl. VAT

€27,000

50% paid

Next payment excl. VAT

€21,600 · 01-10.07.2026

Payment schedule

€27,000

Paid

20.03.2026

⌄

Payment

First payment to supplier

Contract amount

€27,000

VAT

€5,400

Invoice total

€32,400

€21,600

Upcoming

01-10.07.2026

⌄

Payment

Second payment: 40%

Schedule phase

Foundation / Production

Contract amount

€21,600

VAT

€4,320

Invoice total

€25,920

€5,400

Scheduled

After acceptance protocol

⌄

Payment

Final payment: 10%

Schedule phase

Assembly

Contract amount

€5,400

VAT

€1,080

Invoice total

€6,480

Site Preparation Agreement

€20K

Completed ⌄

Contract value excl. VAT

€20,000

Paid excl. VAT

€21,000

Remaining excl. VAT

€0

100% paid

Next payment excl. VAT

None scheduled

Payment schedule

€11,000

Paid

13.11.2025

⌄

Payment

Demolition and site preparation

Schedule phase

Site preparation

Demolition of old structure and site preparation.

Contract amount

€11,000

VAT

€2,200

Invoice total

€13,200

€10,000

Paid

25.06.2026

⌄

Payment

Site works and hydrology correction

Schedule phase

Contracts / Site preparation

Site works, stream/hydrology correction, and related preparation works. This payment also covered the IKEA kitchen order.

Contract amount

€10,000

VAT

€2,000

Invoice total

€12,000

Project Additions

€8.7K

Active ⌄

JYSK is visible as a customer-paid project expense and is excluded from LIND.HOMES collected payments. The IKEA kitchen order was covered from the Site Preparation payment and is not counted again.

Contract value excl. VAT

€8,697

Paid excl. VAT

€1,997

Remaining excl. VAT

€6,700

23% paid

Next payment excl. VAT

€2,000 · To confirm

Payment schedule

€1,997

Paid

25.04.2026

⌄

Payment

JYSK furniture order

Vendor

JYSK

Category

Furniture

JYSK furniture order for the Kiten / KOIVU project.

Paid directly by customer. Visible as a project-related customer expense and excluded from LIND.HOMES collected payments.

Contract amount

€1,996.78

VAT

€399

Invoice total

€2,396

€3,721

Paid

28.06.2026

⌄

Payment

Kitchen order

Schedule phase

Contracts

Vendor

IKEA

Category

Kitchen

IKEA kitchen order for the Kiten / KOIVU project.

Covered from Site Preparation payment. Not counted again in project paid totals.

Contract amount

€3,720.86

VAT

€744

Invoice total

€4,465

€2,000

! Attention Required

To confirm

⌄

Payment

Hydrology correction

Additional site hydrology correction works required after discovery of a stream/waterflow risk affecting the house location.

Contract amount

€2,000

VAT

€400

Invoice total

€2,400

€4,700

! Attention Required

To confirm

⌄

Payment

Building permit cost increase

Additional permitting and documentation cost identified during the approval process.

Contract amount

€4,700

VAT

€940

Invoice total

€5,640

Weekly updates

Customer updates

Completed KOIVU timber facade with panoramic glazing and entrance door
1 photo · Oct 8

Week 9 · Oct 8

KOIVU exterior ready for delivery

Published

The latest factory photo shows the finished timber facade, panoramic glazing, entrance door and exterior lighting. Overall production is recorded at 85%.

View update

Done

  • Timber facade completed
  • Panoramic glazing and entrance door installed
  • Exterior lighting installed
  • Production readiness recorded at 85%

Next

  • Complete the remaining production scope
  • Finalize carrier coordination for delivery on 16 Nov 2026

No customer action needed

KOIVU timber module frame under construction
6 photos · Jul 30 - Aug 11
OSB wall sheathing installed on the KOIVU module
KOIVU module frame, walls and roof structure assembled
Mineral wool insulation installed in the walls and ceiling
Standing-seam metal roof installed
Exterior membrane, battens and upper glazing installed

Week 7 · Jul 30 - Aug 11

KOIVU production reached 40%

Published

One consolidated production update covers the timber frame, wall sheathing, insulation, roof and exterior envelope instead of repeating the same report for every photo.

View update

Done

  • Structural frame and wall sheathing assembled
  • Wall and ceiling insulation installed
  • Standing-seam roof installed
  • Exterior membrane, battens and upper glazing fitted
  • Production milestone recorded at 40%

Next

  • Complete facade cladding
  • Install exterior doors, lighting and final details

No customer action needed

Completed screw-pile foundation with timber binding and protective mesh
1 photo · Jul 15

Week 5 · Jul 15

Foundation completed 100%

Published

Foundation works were completed on 15 Jul 2026. The completion photo documents the screw piles, timber binding and protective mesh ready for module assembly.

View update

Done

  • Screw-pile foundation completed
  • Timber binding installed
  • Protective mesh installed
  • Foundation readiness confirmed at 100%

Next

  • Continue KOIVU production
  • Prepare the revised delivery sequence

No customer action needed this week

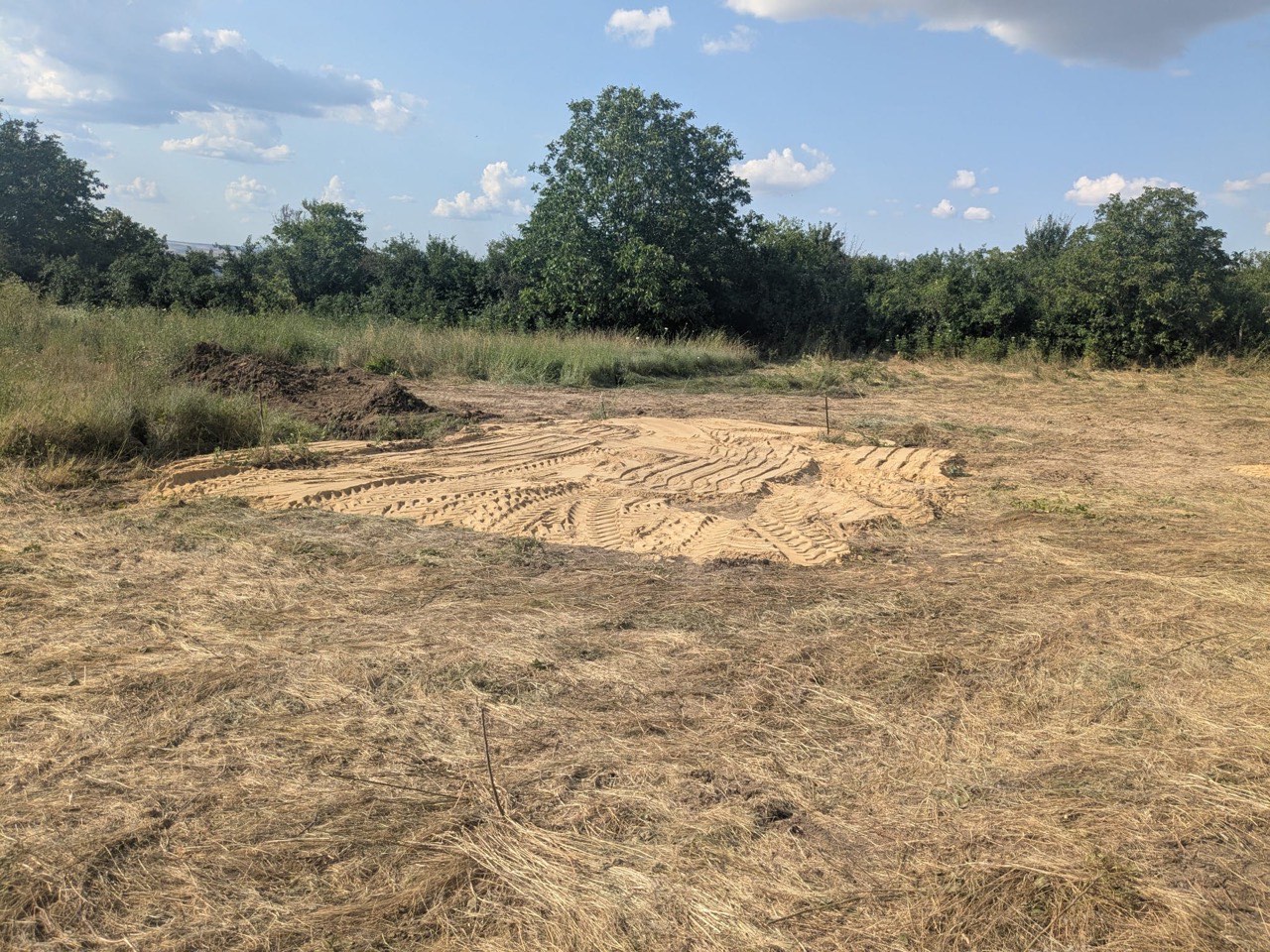

Prepared sand-covered KOIVU house build spot
2 photos · Jul 1 - Jul 7

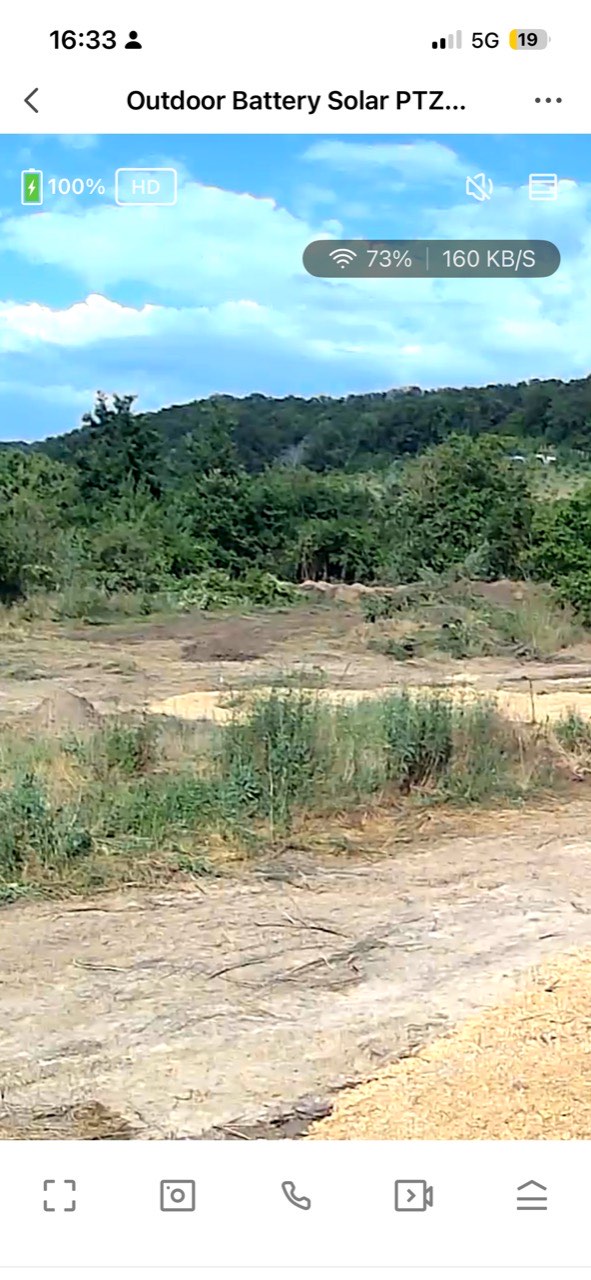

Prepared foundation area viewed from the site camera

Week 3 · Jul 1 - Jul 7

Site ready for foundation

Published

Demolition history, debris removal, septic trench preparation, and final site readiness are archived for the project.

View update

Done

  • Old shed demolition and debris removal archived
  • Site debris removal and septic trench excavation archived
  • Landplot readiness confirmed
  • House build spot leveled and sand prepared
  • Customer update structure prepared

Next

  • Start foundation works
  • Confirm permission milestone

No customer action needed this week

Project gallery

Construction Photos

Completed timber facade with panoramic glazing and entrance door on the KOIVU modulePhase cover
Oct 8, 20261 photoWeek 9

KOIVU house production 85% ready

Timber facade completed with panoramic glazing, entrance door and exterior lighting installed.

Production

Dark standing-seam metal roof installed on the KOIVU moduleExterior windproof membrane and battens installed on the KOIVU moduleMineral wool insulation installed in the KOIVU module walls and ceilingKOIVU timber module frame with walls and roof structure assembledTimber frame of the KOIVU module under construction in the factoryOSB sheathing installed on the exterior wall of the KOIVU module
Jul 30, 2026 - Aug 11, 20266 photosWeek 7

KOIVU house production 40% ready

6 construction photos combined into one progress report.

Production

Timber foundation binding installed on screw piles at the KOIVU sitePhase cover
Aug 1, 20261 photoWeek 5

Foundation completed 100% on 15.07.2026

Screw-pile foundation completed with timber binding and protective mesh.

Foundation

Prepared sand-covered house build spot on the Kiten KOIVU landplotCamera view of the prepared Kiten KOIVU foundation areaExcavated septic pit at the Kiten KOIVU siteExcavator working on septic trench route at the Kiten KOIVU siteCleared site area with soil piles after septic excavationLong septic trench excavated at the Kiten KOIVU siteNarrow trench line for septic works at the Kiten KOIVU siteTruck removing debris from the Kiten KOIVU site after demolitionCleared muddy access area with machinery after debris removalPhase cover
Dec 4, 2025 - Jul 6, 20269 photosWeek 3

Landplot ready for works

9 construction photos combined into one progress report.

Site preparation

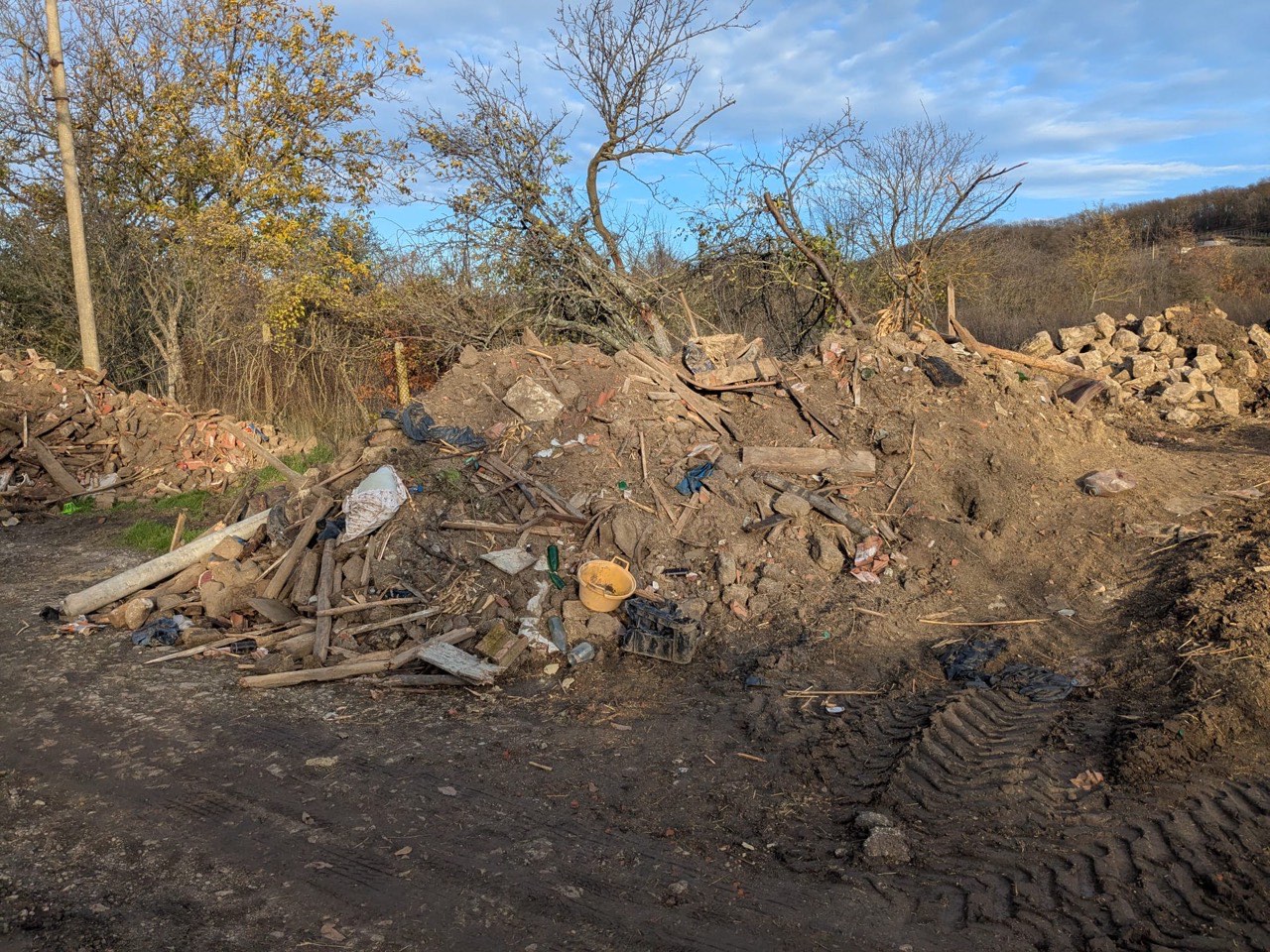

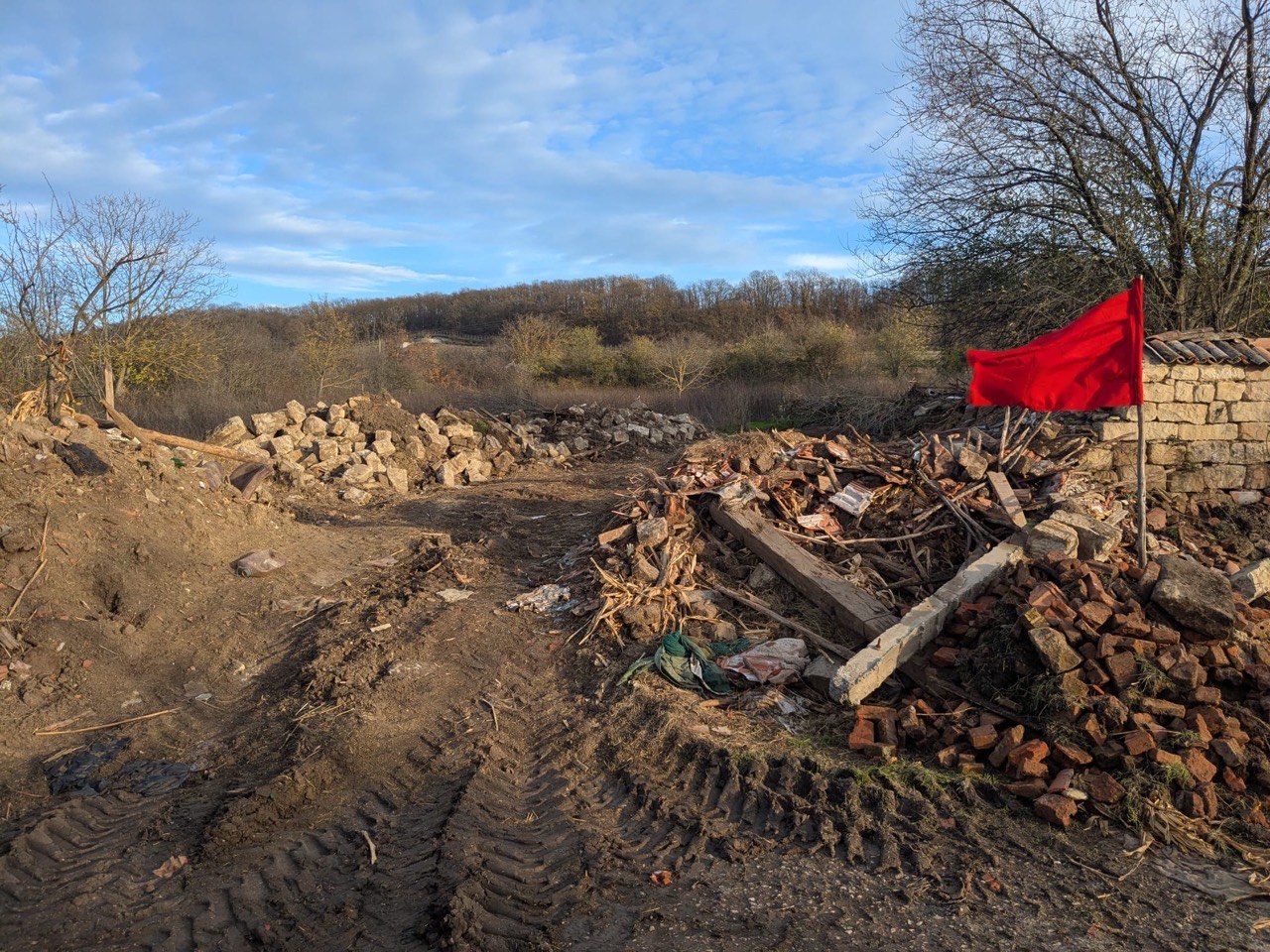

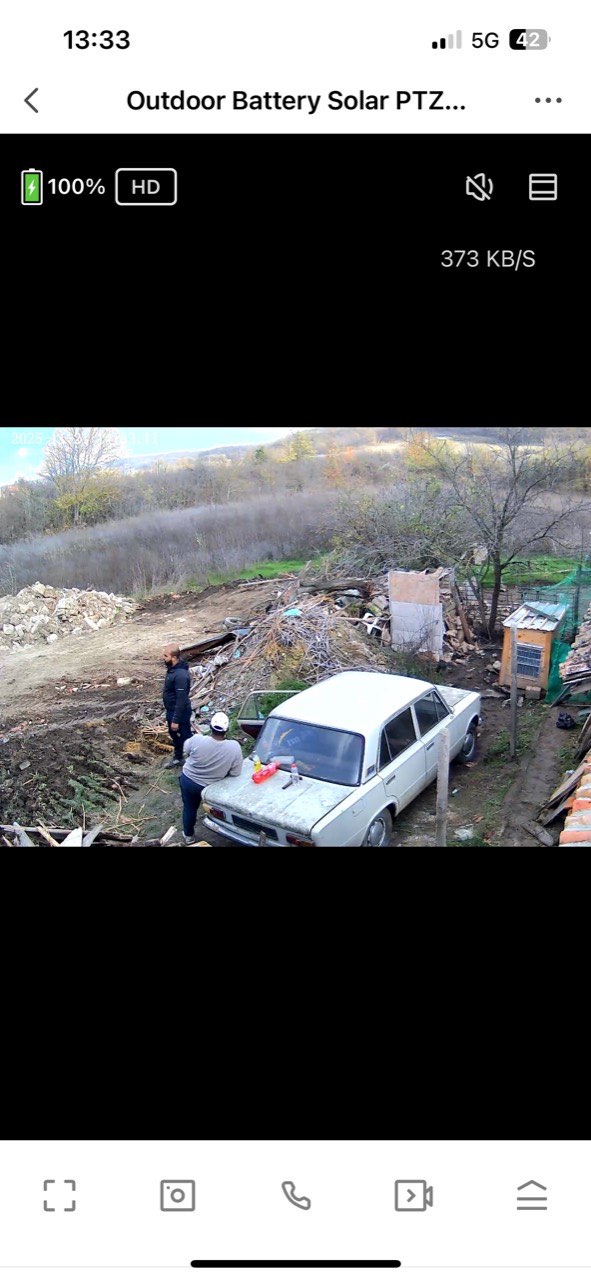

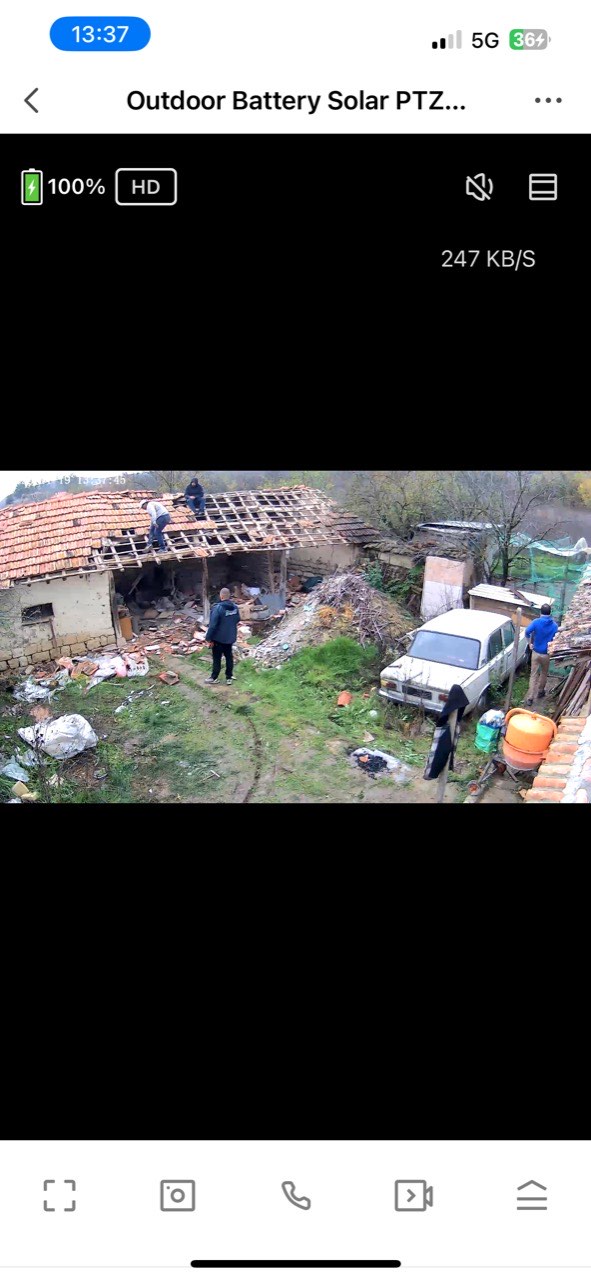

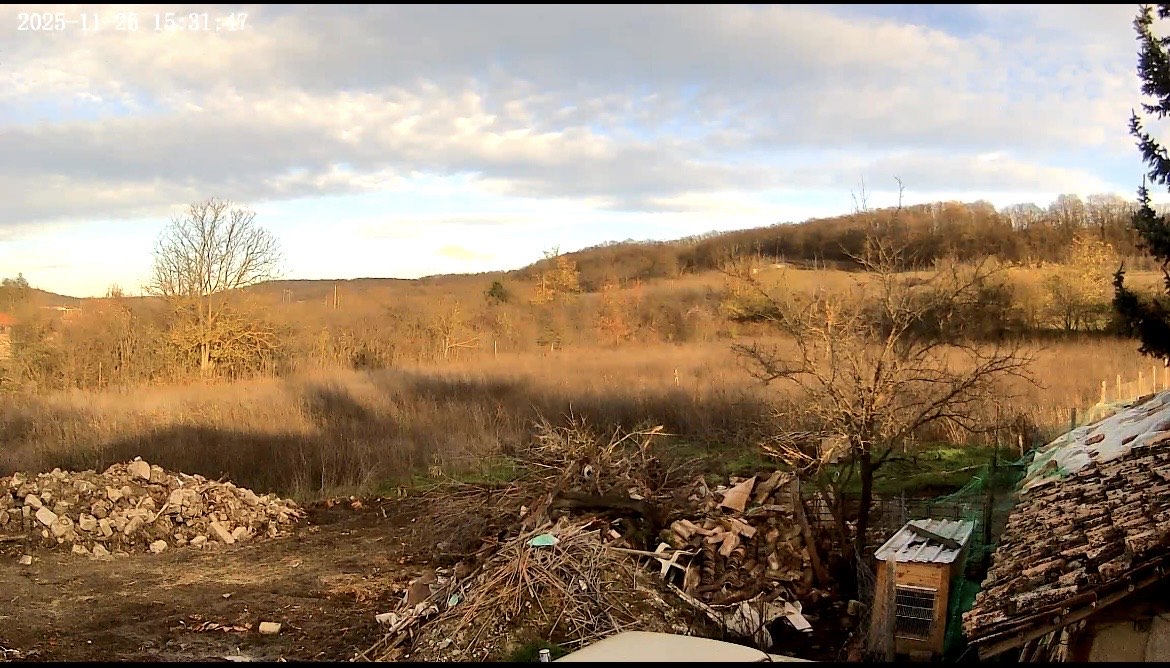

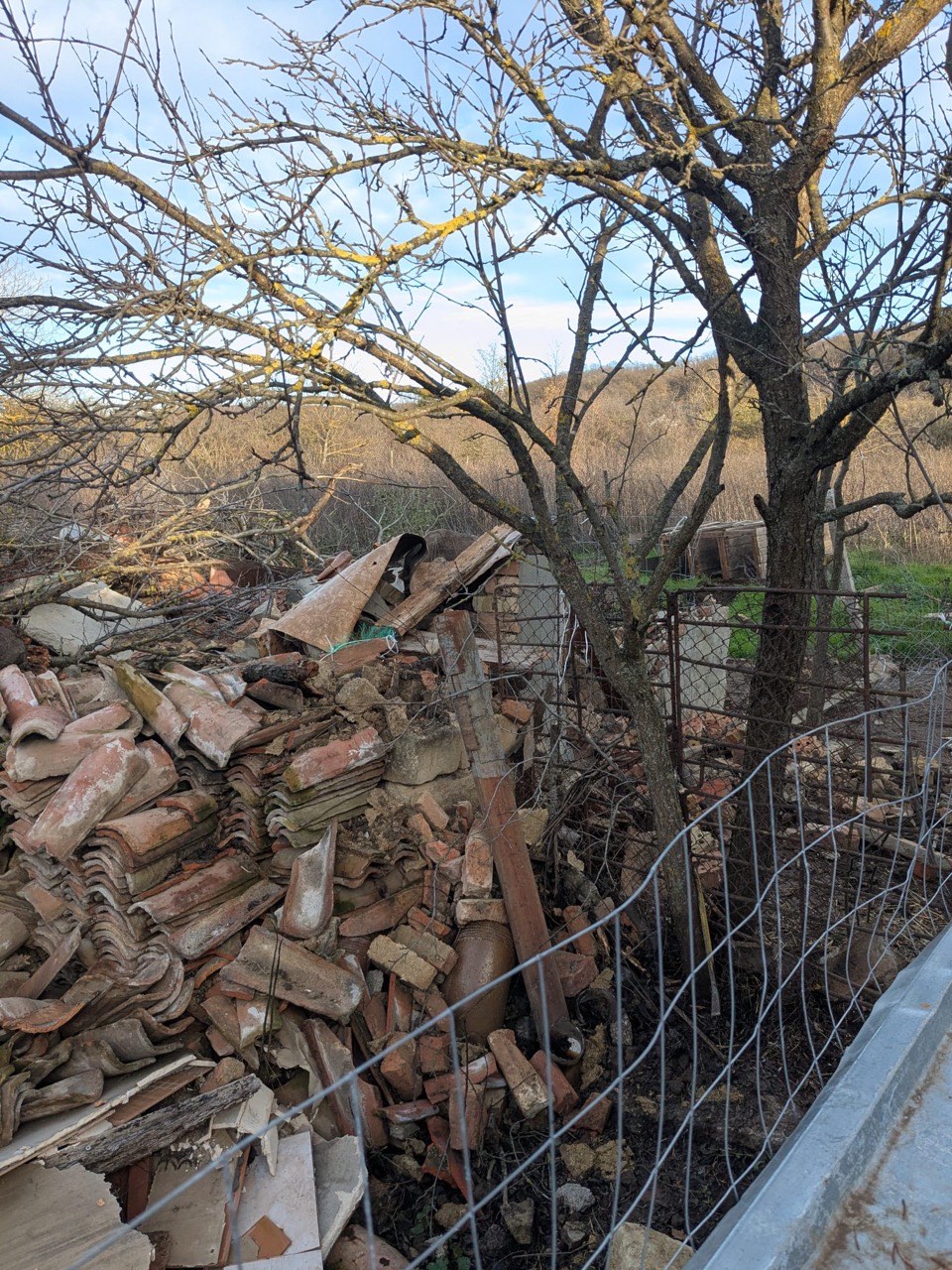

Old shed and debris before demolition at the Kiten KOIVU siteRoof removal during old shed demolition at the Kiten KOIVU siteCleared area and debris piles after shed demolition at the Kiten KOIVU siteDebris piles remaining after old shed demolition at the Kiten KOIVU siteClose view of roof tiles and debris from old shed demolitionCleared access path with demolition debris piles at the Kiten KOIVU siteEarth and debris piles after old shed demolition at the Kiten KOIVU siteCleared passage beside remaining structures after demolition cleanup
Nov 25, 20258 photosWeek 3

Old Building Demolition

8 construction photos combined into one progress report.

Site preparation

Services and options

Add-ons and workstreams

Site Development

✓ Old building demolition

Completed November 2025 ⌄

Previous structure removed before project preparation.

Catalog: Earthworks

approximately €8,000

✓ Site clearing

Completed Completed ⌄

Plot cleared for access and construction preparation.

Catalog: Site Preparation

✓ Access road

Completed Completed ⌄

Access prepared for site works and delivery planning.

Catalog: Site Preparation

✓ Site ready

Completed Completed ⌄

The site is ready for the active foundation workstream.

Catalog: Site Preparation

✓ Foundation

Completed 100% · Completed 15 Jul 2026 ⌄

Foundation works matched to site and house requirements.

Catalog: Screw Pile Foundation

◐ Architectural documentation & permits

In Progress In Progress ⌄

Permit and documentation support for the project.

Catalog: Building Permit

○ Water connection

Upcoming Upcoming ⌄

Connection options depend on local utility availability.

Catalog: Water Connection

○ Electricity connection

Upcoming Upcoming ⌄

Connection type and capacity are confirmed with the provider.

Catalog: Electrical Connection

○ Septic system

Upcoming Upcoming ⌄

System options depend on site and municipality requirements.

Catalog: Septic System

○ Site Project Coordinator

Upcoming Upcoming ⌄

Coordination for upcoming vendor and site workstreams.

Catalog: Site Project Coordinator

House & living

✓ JYSK furniture order

Completed Paid directly by customer ⌄

Furniture order paid directly by the customer.

Catalog: Furniture Assembly

€1,996.78

✓ IKEA kitchen order

Completed Paid ⌄

Kitchen order covered from the Site Preparation payment.

Catalog: Kitchen Installation

Covered from Site Preparation payment
